Torrance Soft Story Retrofit Ordinance 3916: Who's Covered, the Deadlines, and What to Do Now

The City of Torrance adopted Ordinance No. 3916 on March 14, 2023, and it took effect on April 11, 2023. The ordinance requires seismic evaluation and structural retrofit of older buildings that the City has identified as vulnerable to severe damage or collapse during a major earthquake. For most residential property owners in Torrance, the relevant portion is Article 1, which covers existing wood-frame buildings with soft, weak, or open-front walls.

If you own an older apartment building in Torrance with parking or open commercial space underneath the units, Torrance’s soft story ordinance likely applies to you. As of the date this article was last verified, the City has not mailed notification letters to affected properties, and the compliance deadlines in the ordinance do not begin until an owner receives an official Order from the City. No covered building in Torrance is currently behind schedule, and the full five-year compliance window is still ahead of every owner in the program.

Bay Cities Construction is a licensed general contractor headquartered in Torrance, and we handle seismic and foundation work throughout the South Bay, Orange County, and Los Angeles.

What you’ll learn in this article:

• what the ordinance requires • which buildings it covers
• what the timeline looks like once the letters go out
• what owners can do in the meantime

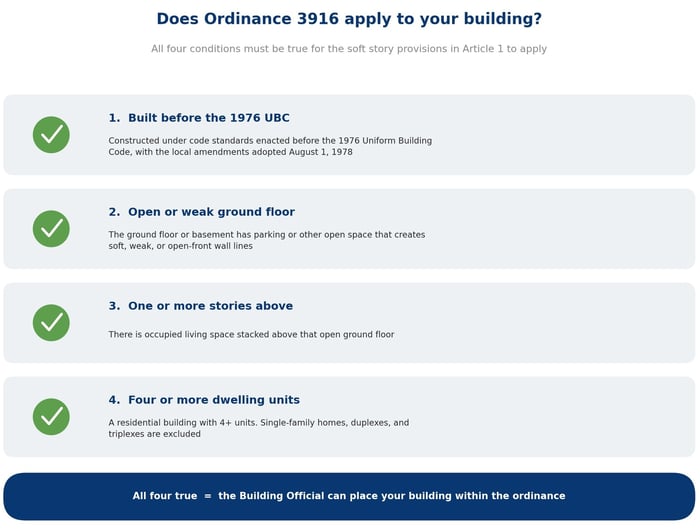

does_the_torrance_soft_story_retrofit_ordinace_apply_to_you_?

What is the Torrance soft story ordinance?

Ordinance No. 3916 was approved unanimously by the Torrance City Council on March 14, 2023 and became effective on April 11, 2023. It establishes a mandatory seismic retrofit program for older buildings constructed under design standards that have since been replaced. The City has stated that Torrance contains hundreds of buildings with potential seismic deficiencies, and that without a mandate to retrofit them there is a high possibility they could be severely damaged during a major seismic event, with the potential for loss of life.

The ordinance addresses four categories of building that the City has identified as carrying the highest risk of significant damage during a large earthquake:

  • Wood buildings with soft, weak, or open-front walls

  • Buildings containing non-ductile concrete, which were typically designed under pre-1980s codes and contain brittle concrete elements with too little steel reinforcement to hold the concrete intact during shaking

  • Buildings with pre-Northridge steel moment frames

  • Buildings with rigid-wall-flexible-diaphragm wall anchorage system deficiencies

Article 1 of the ordinance covers the first category, and that is the portion most residential property owners in Torrance will deal with.

The City defines a wood-framed building with soft, weak, or open-front walls as a multi-story wood structure where the first story is substantially weaker and more flexible than the stories above it; usually because the first floor lacks walls or frames. These buildings were commonly designed before the 1980s and contain large open areas used for tuck-under parking or ground-floor commercial space such as restaurants and convenience stores. During an earthquake, lateral movement concentrates at that weak first story, and without proper strengthening the soft story floor may suffer structural damage or complete failure.

how_does_a_soft_story_fail_in_an_earthquake_?A braced ground floor holds its shape during an earthquake. A soft story racks sideways at the open floor, where the damage concentrates.

Which buildings does Ordinance 3916 apply to?

The soft story provisions apply when the Building Official determines that a building meets the following conditions:

  • The building was constructed under building code standards enacted before the 1976 Uniform Building Code, with local amendments adopted on August 1, 1978.

  • The ground floor or basement portion of the structure contains parking or other similar open floor space that causes soft, weak, or open-front wall lines, or the majority of the ground floor or basement contains open floor space.

  • There are one or more stories above that open ground floor.

  • The structure is a residential building containing four or more dwelling units.

All of these conditions have to be present. A duplex or triplex with tuck-under parking sits below the unit threshold, and a commercial building with an open storefront is not a residential building. Both fall outside Article 1.

In practical terms, the buildings most likely to fall within the ordinance are two- and three-story wood-frame apartment buildings built between the early 1950s and the late 1970s, with cars parked underneath the living units. Torrance has a substantial inventory of this construction type, particularly in the older neighborhoods around Old Torrance and along the corridors where multifamily development was concentrated during that period.does_the_ordinace_apply_to_your_building_torrance_ca

Age by itself does not place a building in scope. A pre-1978 apartment building with a fully enclosed ground floor and continuous perimeter walls does not have the open-front condition the ordinance targets. The determination belongs to the Building Official, and it is made building by building.

  Quick check: is your building likely in scope?
  • Older than the 1976 UBC (roughly pre-1978 construction in Torrance)
  • Parking or open space on the ground floor, with living units above
  • Four or more dwelling units
  • If all three describe your building, plan as though an Order is coming


Has Torrance sent soft story notices yet?

No. As of the last verification date on this article, the City of Torrance states on its Seismic Retrofit Program page that it is in the process of preparing for the implementation stage and that notification letters have not yet been sent to the affected properties.

This matters more than any other detail in the ordinance. The compliance deadlines do not run from the date the ordinance passed. They begin when the owner is served with an official Order from the Building Official. Three years after adoption, no Torrance building owner is late, and no compliance date has passed.

But just because you haven’t received a letter does not mean you’re exempt! The ordinance took effect in April 2023, so it’s enforceable, and Orders will be issued by priority level once the City activates the program.

Owners who want to confirm the status of a specific property can contact the Torrance Community Development Department at 3031 Torrance Blvd, by phone at (310) 618-2550, or by email at seismic@torranceca.gov

What is the compliance timeline once I receive a notice?

Once an Order is served, the deadlines below apply, and each one is measured from the date of that notice.

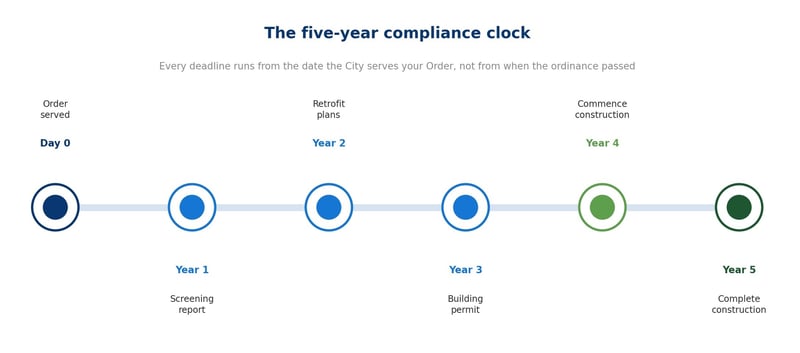

what_is_the_compliance_deadline_for_torrance_soft_story_ordinance

Compliance milestone Deadline from date of Order
Submit screening report prepared by a California licensed design professional 1 year
Submit retrofit plans 2 years
Obtain building permit 3 years
Commence construction 4 years
Complete construction and obtain final approval 5 years


Five years reads as a generous window on paper. Structural engineering, plan check corrections, permit issuance, tenant notification, parking relocation, and the construction itself all consume real calendar time, and owners who wait until year three to begin the engineering often find that the permit and construction milestones arrive faster than they planned for. The screening report deadline in year one sets the pace for everything that follows it.

What are the priority levels, and when will my building be notified?

The ordinance establishes three priority groups that determine the order in which the City issues order notices to owners of buildings expected to fall within its scope.

Priority level Buildings included
Priority I Buildings containing three or more stories
Priority II Two-story buildings containing seven or more units
Priority III Buildings that do not fall within Priority I or Priority II


For example: a three-story building will receive its order before a two-story fourplex on the same street. Owners of Priority III buildings have the longest runway, though the length of that runway will not be clear until the City publishes its notification schedule.

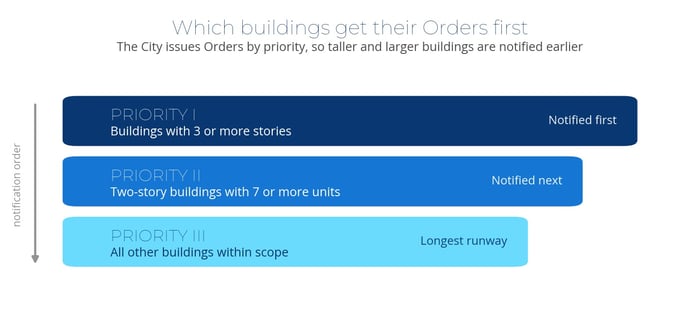

torrance_soft_story_retrofit_ordance_priority_levelsWhat is a screening report, and who can prepare one?

The ordinance requires that buildings within its scope be investigated and analyzed by a California licensed design professional. That analysis produces the screening report, which establishes whether the building meets the minimum seismic standards set out in the ordinance. If it does, the owner documents the finding with the City. If it doesn’t, the owner must complete the required strengthening work within the compliance timeline.

The ordinance requires the investigation and analysis to be performed by a licensed design professional, and it requires the professional to sign a statement on the approved plans taking responsibility for the seismic design.

🏆 Bay Cities works closely with a structural engineering partner who prepares and stamps those plans, and Bay Cities manages the project turn-key from there, coordinating the engineering, the permitting, the construction, and the inspections as one process.

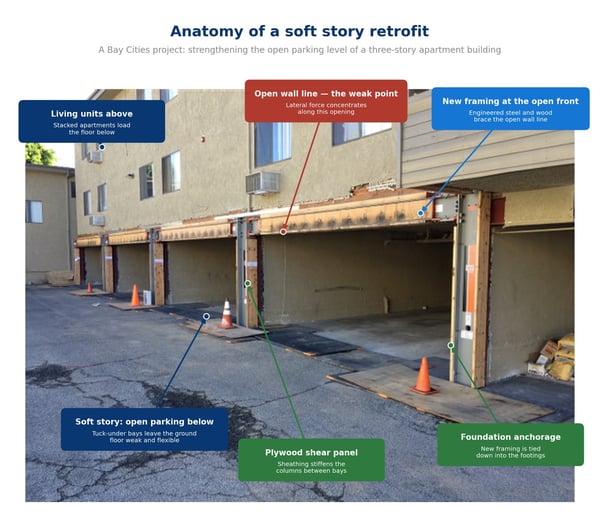

What does a soft story retrofit involve?

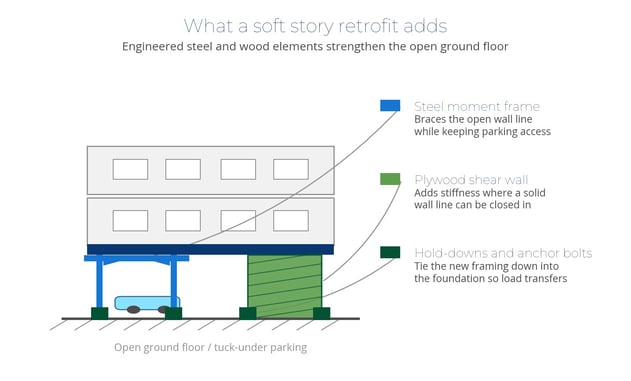

The purpose of the retrofit is to add strength and stiffness at the ground floor opening so the building resists lateral forces without concentrating movement to its weakest story. The specific methods depend on what the engineer specifies, but most projects use some combination of the following:05-retrofit-methodswhat_does_a_soft_story_retrofit_involve

  • Steel moment frames installed across the open wall line, typically at the garage or carport opening, where a solid shear wall would eliminate vehicle access.

  • Plywood shear walls added to existing wall lines, often by replacing stucco or drywall with structural sheathing.

  • Hold-downs and anchor bolts that tie the framing to the foundation so the strengthened walls transfer load into the ground rather than sliding or lifting.

  • Foundation work where existing footings cannot carry the loads that new frames or shear walls introduce.

Keep in mind that the framing itself isn’t what dictates the construction schedule of soft story projects. Parking loss during construction, utility and gas line relocations, garage door and access modifications, and coordination with occupied units account for more of the calendar than the structural work does.

  What dictates the construction timeline
  • Loss of parking access during construction
  • Utility and gas line relocations
  • Garage door and ground-floor access changes
  • Coordinating the work around occupied units


How much does a soft story retrofit cost in Torrance?

Costs on a soft story retrofit are of course based on the building, and severity of damage. These are the variables that decide the cost of the retrofit:

  • The number and width of open bays that require steel frames

  • Whether the existing footings can carry the new loads or need to be enlarged or replaced

  • The condition of the existing framing and foundation, which is not fully known until the walls and slab are opened

  • Access constraints, including whether crews and equipment can reach the garage area

  • The number of occupied units and the amount of tenant coordination required

  • Whether plan check returns structural revisions that change the retrofit approach

The screening report is the point at which the scope becomes specific. Until a licensed engineer has evaluated the building and specified the retrofit approach, any figure is just an estimate built on assumptions about the conditions behind the walls and below the slab. Careful upfront evaluation reduces the number of surprises during construction, but keep in mind just like with any construction, there are some conditions that only become visible once demolition begins and can change the scope- be sure to keep a contingency fund of 10-15% specifically for any unforeseen variables.

Bay Cities Construction prices soft story retrofit work by assessment, based on the extent of the deficiency and the size of the building, and delivers the project turn-key. That means one team coordinates the engineering partner who produces the plans, the permitting through the Torrance Building and Safety Division, the construction, and the inspections, so the owner is not managing an engineer, a contractor, and a permit expediter as three separate relationships.

Free Consultation · Torrance, CA

Think Your Building Needs a Retrofit?

Tell us about your building and we'll walk through whether it falls under Ordinance 3916, what a retrofit would involve, and what the next step should be. If an on-site visit makes sense, we'll schedule that to assess the damage in detail and prepare your quote.

SCHEDULE A FREE CONSULTATION →


What happens if I don’t comply with the Torrance Soft Story ordinance?

A building found to be within the scope of the ordinance that is not brought into compliance within the timeframe may be declared unsafe and made subject to Section 116 of the California Building Code, which governs unsafe structures.

The ordinance also carries a penalty provision:

  • A violation is a misdemeanor unless the City reduces it to an infraction, and each day the violation continues is treated as a separate offense.

  • On conviction, the penalty can reach a fine of up to $1,000 per day, up to six months in jail, or both, and those penalties are in addition to any other costs the City is entitled to recover.

In practice the City works through orders, appeals, and extensions long before penalties enter the picture, but the enforcement authority is real and it’s written into the code.

There is one more consequence worth understanding. If a building misses its deadlines, the Building Official can record a certificate with the Los Angeles County Recorder stating that the building is within the scope of the ordinance and requires retrofit. That recording attaches to the property record, where a buyer, a lender, or a title company will find it. Once the building is retrofitted and in compliance, the Building Official records a certificate clearing it.



How non-compliance escalates

  • The building can be declared unsafe under CBC Section 116
  • A violation is a misdemeanor, with each day a separate offense
  • Penalties can reach $1,000 per day, up to six months, or both
  • The City can record a certificate against the property that a buyer or lender will find


Can I appeal the determination or ask for more time?

Yes to both, and the two work differently.

An owner who believes the Building Official has wrongly placed the building within the scope of the ordinance, or wrongly concluded it must be retrofitted, can appeal to the City Manager. The appeal has to be filed within 30 days of the Building Official's order or decision, and the City Manager decides it within ninety days of filing. Filing the appeal stays the underlying order and its time limits while the appeal is pending, so the compliance clock pauses. If the appeal is denied, the original time limits are restored unless the City Manager sets new ones.

An extension works differently, and the timing rule surprises owners. An extension request cannot be filed at the start. Under the ordinance it may only be filed after the owner has already submitted the screening report and had the retrofit plans approved by the City. An owner has to be through the first two milestones before asking for more time on the ones that follow. The owner carries the burden of showing good cause with substantial evidence, such as documented difficulty securing funding or a contractor despite best efforts, and has to submit a new proposed compliance schedule. The Building Official can then approve it, approve it with modifications, or deny it.

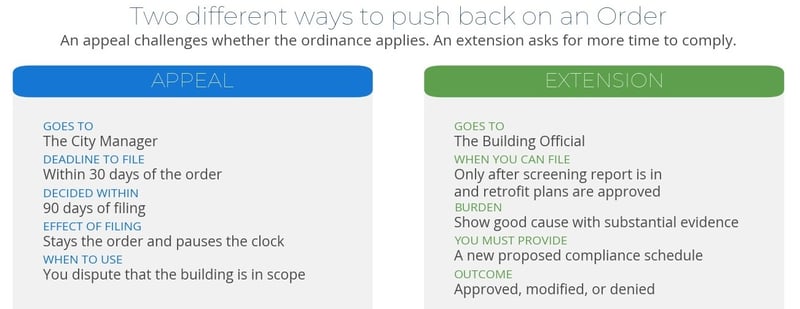

06-appeal-vs-extension

Do the state earthquake grants cover my apartment building?

No, in almost every case. Two state programs administered through the California Residential Mitigation Program now cover all Torrance ZIP codes, and neither one funds the retrofit of an apartment building under Ordinance 3916.

Earthquake Brace + Bolt (EBB) provides up to $3,000 for eligible wood-frame homes with raised foundations, with supplemental funding available for income-qualified households. As of 2025 the program also accepts non-owner-occupied homes, including rentals, though it remains a brace-and-bolt grant for raised-foundation houses rather than a soft story program. Earthquake Soft-Story (ESS) provides up to $13,000 for owner-occupied homes with living space built over a garage, and the home must have been built before 2000 to qualify.

Both programs fund single-family and small residential structures, not the four-plus unit buildings the ordinance covers. If you own an apartment building that falls within Ordinance 3916, plan on financing the retrofit yourself. If you own a house in Torrance with living space above the garage, the ESS program is worth applying for whether or not the ordinance touches your property.

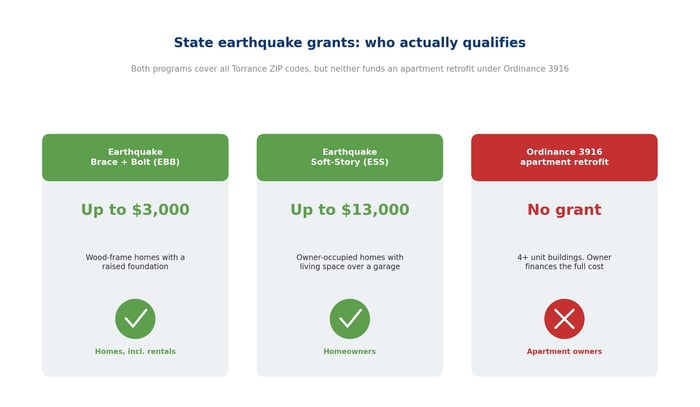

07-state-grants-eligibility

Will a seismic retrofit raise my property taxes?

Not the seismic portion of the work, provided you file for the exclusion. California Revenue and Taxation Code section 74.5 states that new construction does not include the portion of an existing structure consisting of the construction or reconstruction of seismic retrofitting components, but that portion is excluded from reassessment.

Several contractor websites summarize this as a flat statement that a retrofit will not increase your assessed value. The statute is narrower than that, and the details matter to the building owner:

  • Only the certified seismic components are excluded. However plumbing, electrical, and finishing materials added alongside the seismic work are not covered, and they can be reassessed.
  • The owner, primary contractor, civil or structural engineer, or architect certifies to the building department which exact portions of the project are seismic retrofitting components.
    • The building department then reports those costs to the county assessor.
  • The owner has to notify the assessor of the intent to claim the exclusion before the project is complete, or within 30 days of completion.
    • Supporting documents are due within six months of completion.
  • The exclusion doesn’t apply to seismic components of an entirely new structure, only to retrofit of an existing one.

Owners of buildings in Torrance file with the Los Angeles County Assessor, using the claim form the State Board of Equalization prescribes. The filing deadline is the part owners miss most often, because it’s based off the completion date rather than the tax year.

How does the Torrance ordinance compare to the Los Angeles one?

Owners who hold buildings in both cities will find the two ordinances similar in structure and different in the details that affect planning.

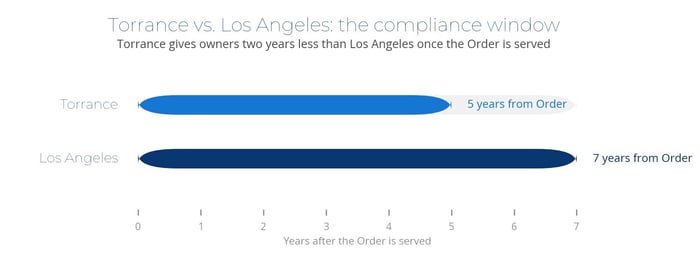

08-torrance-vs-la-window

  Torrance (Ord. 3916) Los Angeles (Ord. 183893)
Adopted March 14, 2023 2015
Effective April 11, 2023 2015
Buildings identified Hundreds, final count not published Approximately 13,500 wood-frame soft story
Compliance window 5 years from Order 7 years from Order
Clock starts Service of the Order Service of the Order
Orders issued Not yet as of last verification Issued beginning 2016
Local rent stabilization None. AB 1482 applies statewide RSO applies to pre-Oct 1978 rentals
Retrofit cost recovery No local pass-through program Up to 50% of cost, surcharge capped at $38/month for 120 months, LAHD approval required


The cost recovery line item is the main difference. An owner of a rent-stabilized building in Los Angeles can
apply to the Los Angeles Housing Department to recover half the retrofit cost from tenants through a temporary monthly surcharge, capped at $38 per unit and running up to 120 months. Torrance has no local rent stabilization ordinance and no equivalent cost recovery program, so rent increases are governed by the statewide Tenant Protection Act.

A Torrance owner should plan on carrying the full cost of the retrofit. Owners with questions about what rent increases their specific tenancies allow should speak with an attorney, since Bay Cities Construction does not give legal advice.

The city of Torrance gives owners a window two years shorter than the one Los Angeles gave. Los Angeles also had years of program administration, published building inventories, and an established plan check pathway before most owners began work. Torrance owners will enter a program that is still being stood up, which in other cities has meant slower plan check during the early cycles and a smaller pool of contractors with local ordinance experience.

What should Torrance building owners do before the notices go out?

The notification letters have not been mailed, which gives Torrance owners a window that owners in Los Angeles and Santa Monica never had. The work that can be done ahead of the Order is the work that shortens the timeline once it arrives.

  • Pull the permit history and confirm the year of construction and the code cycle the building was permitted under.
    • The City's determination rests on that date.
  • Document the ground-floor condition with photographs of every open wall line, the parking area, the garage openings, and the columns supporting the units above.
  • Get a preliminary structural opinion so the screening report is not the first time an engineer has looked at the building.
  • Plan for the parking- On most soft story retrofits tenants lose garage access for part of the construction period, and having a plan in place before the Order arrives removes one of the more common sources of delay.
  • Understand the foundation- Soft story frames transfer load into the footings, and footings on a 1960s apartment building were not designed to receive it.

Bay Cities Construction has been a licensed general contractor for more than twenty years, serving Los Angeles, the South Bay, and Orange County. If you own a building that may fall within Ordinance 3916, we can walk the property, assess the ground-floor condition and the foundation, and coordinate the engineering and permitting that compliance requires.

  Before the notice arrives, you can
  • Pull the permit history and confirm the construction year
  • Photograph the ground-floor and parking condition
  • Get a preliminary structural opinion ahead of the screening report
  • Plan for parking loss during construction
  • Understand the foundation the new frames will load


See the Signs in Person

If Ordinance 3916 applies to your building, you have time to plan the work before the City sends your notice. Knowing what your building needs now puts you ahead of the deadlines.

📝

Talk to us about your building

Every soft story retrofit is priced on the building, damage, and the size of the job. Tell us about your property and we will scope the work and give you an estimate built around it.

Request a Quote
📷

See our work first

See our completed retrofit, foundation, and remodeling work across the South Bay, Los Angeles, and Orange County before you reach out.

View the Gallery
